Remodel Permits in Los Angeles (2026): LADBS, HPOZ, Coastal Zones, and Real Timelines

Remodel Permits in Los Angeles (2026): LADBS, HPOZ, Coastal Zones, and Real Timelines

Start here: which city is your house actually in?

"Los Angeles" is not one permitting authority. The City of LA runs LADBS. Santa Monica and Beverly Hills run their own building departments with their own timelines and their own personalities. A remodel in Mar Vista (City of LA) and a remodel twenty minutes away in Santa Monica follow different rules, different fee schedules, and different queues. The first thing we check on any project is jurisdiction, before design and before pricing.

LADBS: the City of LA baseline

For most City of LA remodels there are two roads. Smaller, non-structural projects (water heater swaps, reroofs, like-for-like kitchen and bath work) can qualify for express permits, often issued same-day or over the counter. The moment your project moves walls, touches structure, or changes the building footprint, you're in plan check, where a complete, well-prepared set of drawings is the difference between weeks and months. In our experience, the projects that crawl are the ones submitted with gaps: missing structural calcs, vague scope, no Title 24 energy documentation. We budget 4-12 weeks of pre-construction time for design, selections, and permits on typical remodels, and we front-load the drawing quality so plan check has nothing to bounce.

The overlay that changes everything: HPOZ

If your home sits in one of LA's Historic Preservation Overlay Zones, every piece of exterior work gets an extra layer of review against the neighborhood's Preservation Plan. Big stretches of Mid-City sit in one, including the Miracle Mile HPOZ and its 1,347 properties. Interior work is generally yours to design. Paint color is exempt. But windows, additions, and anything visible from the street goes through HPOZ review before LADBS will issue. The system is workable if your drawings respect the district's character from the first submission; it's painful if you design first and ask questions later. We cover the full playbook in our HPOZ remodeling guide.

The Coastal Zone: a different clock entirely

Within the Coastal Zone (in Santa Monica it generally runs from the beach inland to Lincoln Boulevard), projects that change the structure's footprint, raise the roofline, or change the intensity of use can trigger a Coastal Development Permit on top of standard review. Purely interior cosmetic work is generally exempt. But a CDP is not a formality. Depending on the project it can add many months, and in contested cases the timeline runs past a year and a half. If you're buying near the beach with a major remodel in mind, this belongs in your purchase math. More in our Santa Monica whole-home guide.

Santa Monica and Beverly Hills: separate cities, separate queues

Santa Monica currently runs same-day review for minor scopes and an 8-12 week plan check for standard projects. Once your remodel moves walls, plumbing, or electrical, plan on three to four months minimum from application to construction start. Beverly Hills has its own review culture and is famously detail-oriented on anything visible from the street. We've permitted in both. The work is in knowing each department's checklist before submission, not after the first correction letter.

What got faster in 2026

Two bright spots. ADUs are now on a state-mandated clock: under SB 543, applications must be deemed complete within 15 business days and decided within 60 days, and LADBS pre-approved standard plans are turning permits around in about three to four weeks. And for fire-affected properties, the rebuild fast-track lanes created after January 2025 are producing permits dramatically faster than normal plan check. We break down the current numbers in our Palisades rebuild guide.

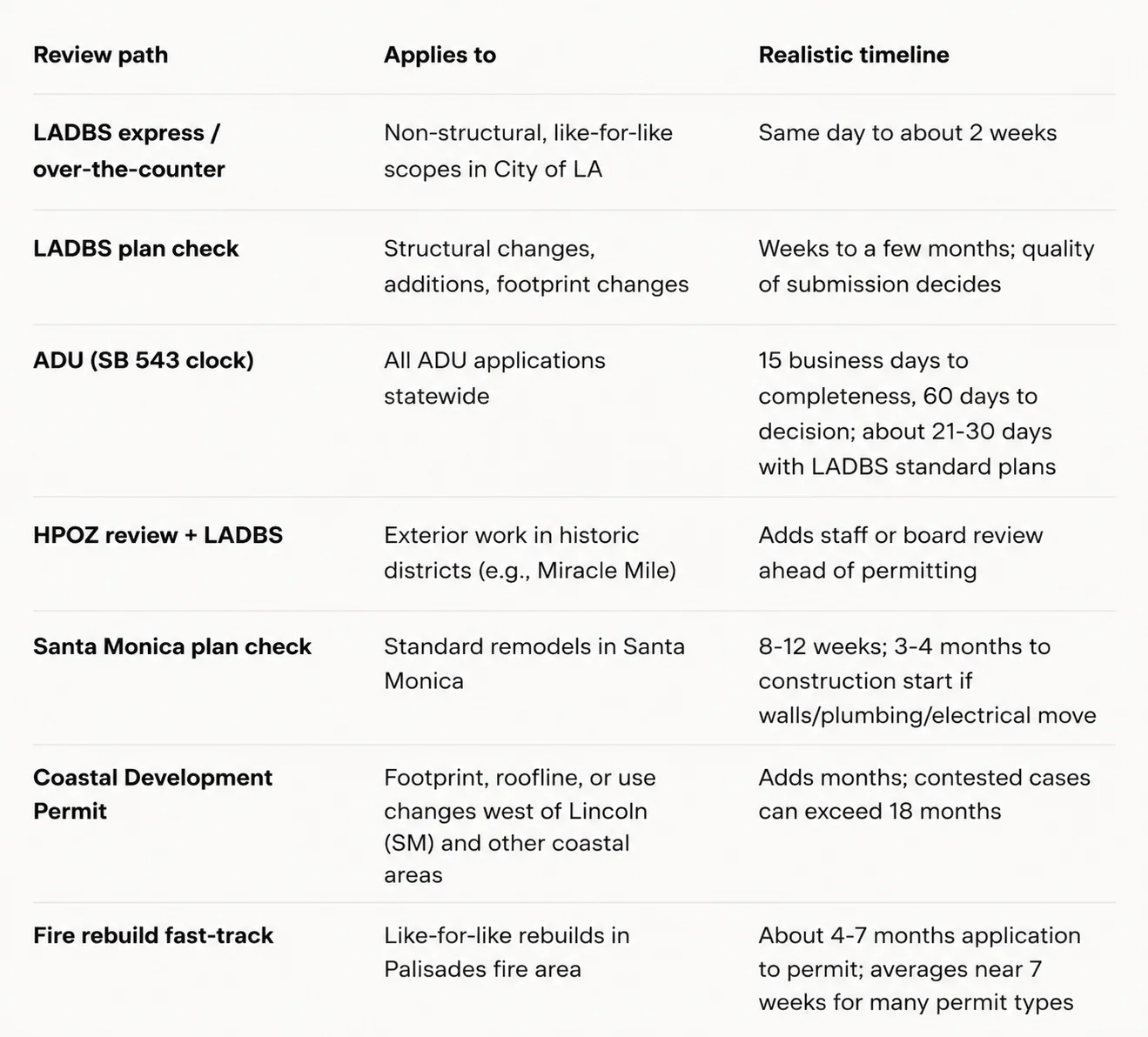

Timelines at a glance (mid-2026)



Common questions

How long does a remodel permit take in Los Angeles in 2026? Express-eligible scopes: days. Standard plan check on a well-prepared remodel: typically inside our 4-12 week pre-construction window. Add HPOZ or Coastal review and the calendar grows, which is why we sequence design around the review path from day one.

Can I remodel without a permit? You can, the way you can drive without insurance. Unpermitted work surfaces at sale, kills deals, and can force open-wall inspections years later. Every Forma job is permitted and inspected. No exceptions.

Who pulls the permit, me or the contractor? Your contractor should, under their license. A contractor who asks you to pull an owner-builder permit is moving liability onto you. That's a red flag worth walking away from.

Do permits really cost that much? Permit fees themselves are usually a small fraction of project cost. What costs money is time. A stalled permit means a paid design team and a locked-in contractor waiting. Submission quality is the cheapest schedule insurance there is.

We coordinate design and permits in-house on every project: LADBS, HPOZ, Coastal, Santa Monica, Beverly Hills. Schedule a consultation. Forma Homes | CSLB #1140511.
